Most cost breakdowns fall apart before anyone has even opened the drawings properly. You get handed a package, a deadline and a client who wants a number by Friday, so the temptation is to price it off gut feel and tidy it into a breakdown afterwards. Every shortcut taken at this stage gets carried straight through to the final account, usually as a loss.

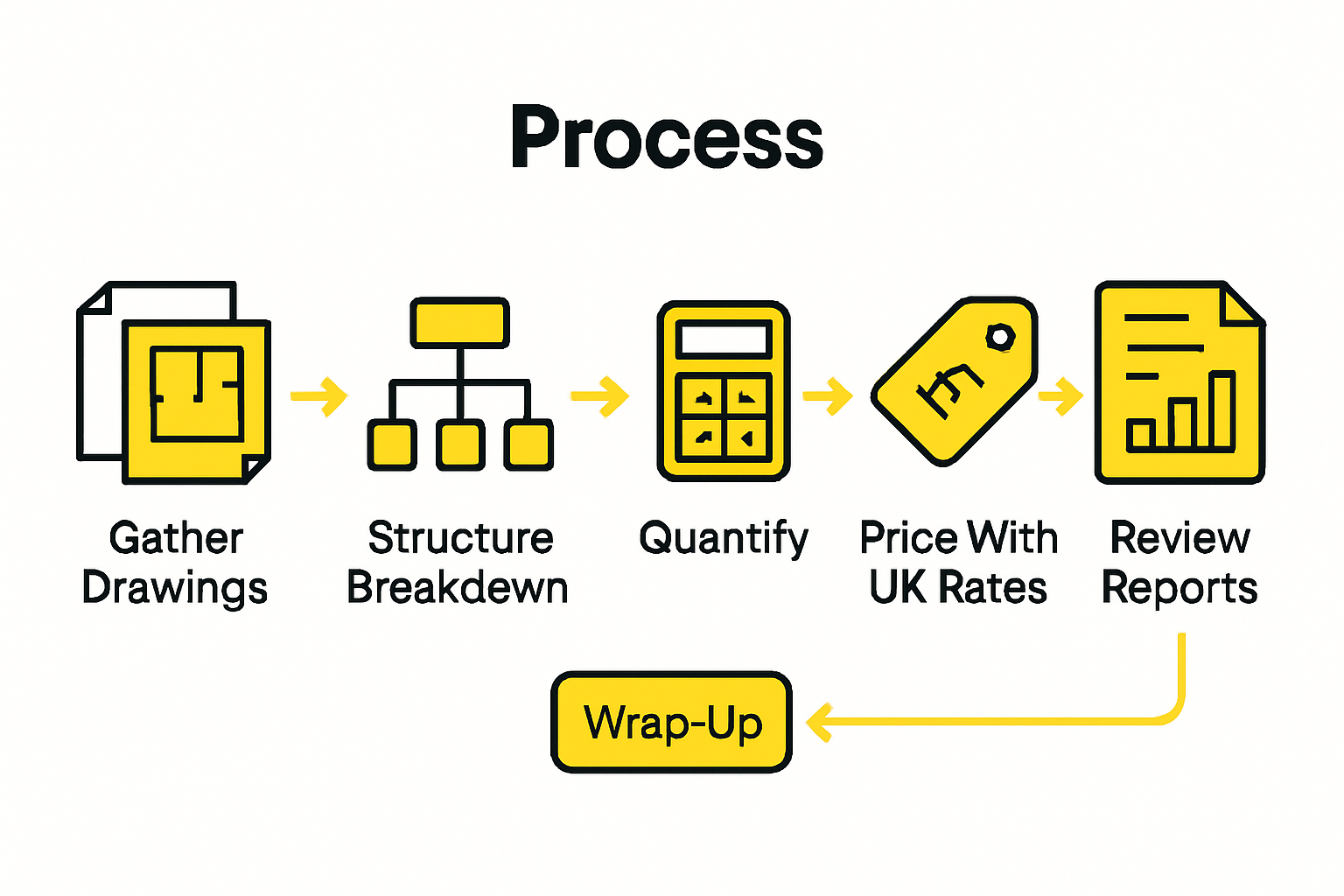

A construction cost breakdown workflow fixes the order you do things in. It is not about extra work. It is about doing the same work in a sequence where each step catches the mistakes of the one before.
Where the numbers start slipping
The slip usually happens in one of three places. The information was never read properly, so something shown on a drawing never got priced. The breakdown was built after the price, so it reflects what the estimator wanted the total to be rather than what the job costs. Or the elements were priced as round figures, so nobody can tell later what each one contained.
Each of those is a workflow problem, not a skill problem. Good estimators make all three mistakes when the process lets them, usually late at night with the deadline the next morning. A fixed order of work takes the decision out of it: you read, then you split, then you measure, then you price, then you check, whatever the time.
Start with what you have actually been given
Before you measure a single item, go through the drawings and the specification page by page. Note what is missing, what is marked "to be confirmed", and where the drawings and specification contradict each other. Any gap here becomes an assumption you have to price around, and unpriced assumptions are where arguments start six months into the job.
Keep a running list and give each item a status: queried, assumed, or excluded. By the end of pricing, nothing on that list should still be blank.
This is also the moment to check the drawing issue. Make sure every sheet you are about to measure from is the latest revision, and note the revision numbers. If the client issues new drawings halfway through the tender period, you will know exactly which parts of the breakdown need revisiting instead of starting again.
The construction cost breakdown workflow, element by element
Once you know what is actually being priced, split the job into elements so the breakdown lines up with how the job will be built, measured and valued. NRM2 allows a bill to be structured by element, by work section or by work package; for most building jobs an elemental split reads most naturally to a client.
- Set the elements. Substructure, frame, upper floors, roof, external walls, windows and doors, internal walls, finishes, services, external works. Add preliminaries as its own section.
- Measure within each element. Take off every item to NRM2, with a reference to the drawing and revision it came from.
- Price each item on its own merits. Labour, plant and materials priced against the item they actually belong to, not lumped into one round figure.
- Add subcontract packages to the right element. With a note of whether each is a firm quote or an allowance.
- Price preliminaries against the programme. Fixed items separate from time-related ones.
- Add overheads, margin and contingency last. As visible lines, with written reasons for the contingency.
Measure it this way and when a variation lands mid-contract, you can point straight to the element it sits under instead of arguing about where it belongs.
Price each element on its own merits
This is the part that takes real time, and it is the part that gets skipped when the tender deadline is tight. Skip it and you are carrying risk you never priced for in the first place.
A hypothetical shows why. Say the external walls on a small block are priced as one round figure per square metre borrowed from a previous job. That job had plain facing brick. This one has a band of feature brickwork, stone cills and a section of render on insulation. The round figure hides all three differences. Priced item by item, each one gets its own quantity and rate and none of them can disappear.
The same goes for labour. An output rate that suits a long straight run of blockwork will not suit a wall broken up by openings every couple of metres. Pricing at item level forces you to think about how each part of the element actually gets built, which is where most of the accuracy comes from.
A breakdown built after the price is a story about the number. A breakdown built before it is the number. Only one of them holds up when the client's QS starts asking questions.
Check it before it goes out the door
Before submission, run back through the breakdown against the drawings one more time. Check quantities against the schedules, check nothing is priced twice, check nothing has been missed off entirely. A second pass at this stage catches the errors that would otherwise surface as a loss further down the job.
The elemental structure makes this check faster. You can compare each element against the drawings that cover it, and against the same element on a similar past job. If the roof looks cheap relative to the floor area, you know where to look. The same structure also feeds straight into cost planning services on the next scheme, because the elements carry across.
For more on what the finished document should show a client, see splitting direct costs, indirect costs and risk.
One test for your breakdown
Pick any element and ask: could someone who did not price this job trace every pound in it back to a drawing and a rate? If they could, your construction cost breakdown workflow is working. If some of it is a round number with no source, that is the element to re-price before the tender goes out.
